A proof of concept across two residential projects caught 92 design coordination issues before construction. On an average project, Buildcheck saved RM 316,086 against an RM 16,800 investment.


return on investment
issues caught before construction
savings per project (average)
of schedule saved per project
On this page
For every RM 1 spent on Buildcheck, Setia saves RM 18.80 in avoided costs.
Setia ran Buildcheck as a proof of concept on two residential projects: multifamily townhomes and apartments. Across both drawing sets, Buildcheck caught 92 design coordination issues before construction.
The ROI analysis is modelled on an average project — RM 32.5M estimated hard cost and 168 sheets reviewed — and puts the benefit at RM 316,086 against an investment of RM 16,800: RM 1,881 per sheet.
Without automated design review, errors propagate to construction sites as RFIs and change orders, causing schedule delays and budget overruns.
Setia set a clear bar for the proof of concept: achieve more than 10x ROI through quantified savings from prevented RFIs, change orders and time savings — using pre-agreed values for the cost and schedule impact of design errors.
Buildcheck reviewed the drawings for both projects with 200+ AI-powered checks across all major disciplines and drawing types. Every issue came back with a natural language description, visual clouding and a severity ranking, grouped by related issues and disciplines.
On the townhomes, 40 issues were flagged for action; on the apartments, all issues were flagged and tracked.
89% of savings come from avoiding schedule delays and RFIs — the most expensive consequences of design errors.

Schedule delays are the biggest cost driver. Avoided RFIs saved 40.3 days and faster design revisions another 2.5 — 42.8 days on an average project, worth RM 152,438 in schedule delay costs.
Construction loan interest rate 5% · Loan to value 80% · Daily carry on RM 32.5M: RM 3,562
The analysis assumes 70% of the issues found would have become RFIs. Each RFI requires ~6 business days of coordination across departments. By catching issues before they become RFIs, Buildcheck eliminates this administrative burden — RM 128,800 saved per project.
31 RFIs avoided per project · RM 4,000 average cost per RFI · 26-day average RFI response time · 5% critical-path RFIs
Fewer VOs (variation orders) reaching the construction phase, and reduced rework and material waste — RM 30,940 saved in change orders per project.
RM 32.5M average estimated hard cost · 0.16% industry cost overrun rate (risk-weighted due to VO) · 85% of cost overruns linked to drawings · 70% Buildcheck catch rate
Time saved across internal review, design meetings and coordination — RM 3,908 combined per project.
Internal review time RM 2,226 · Meeting efficiencies RM 870 · Coordination efficiencies RM 812

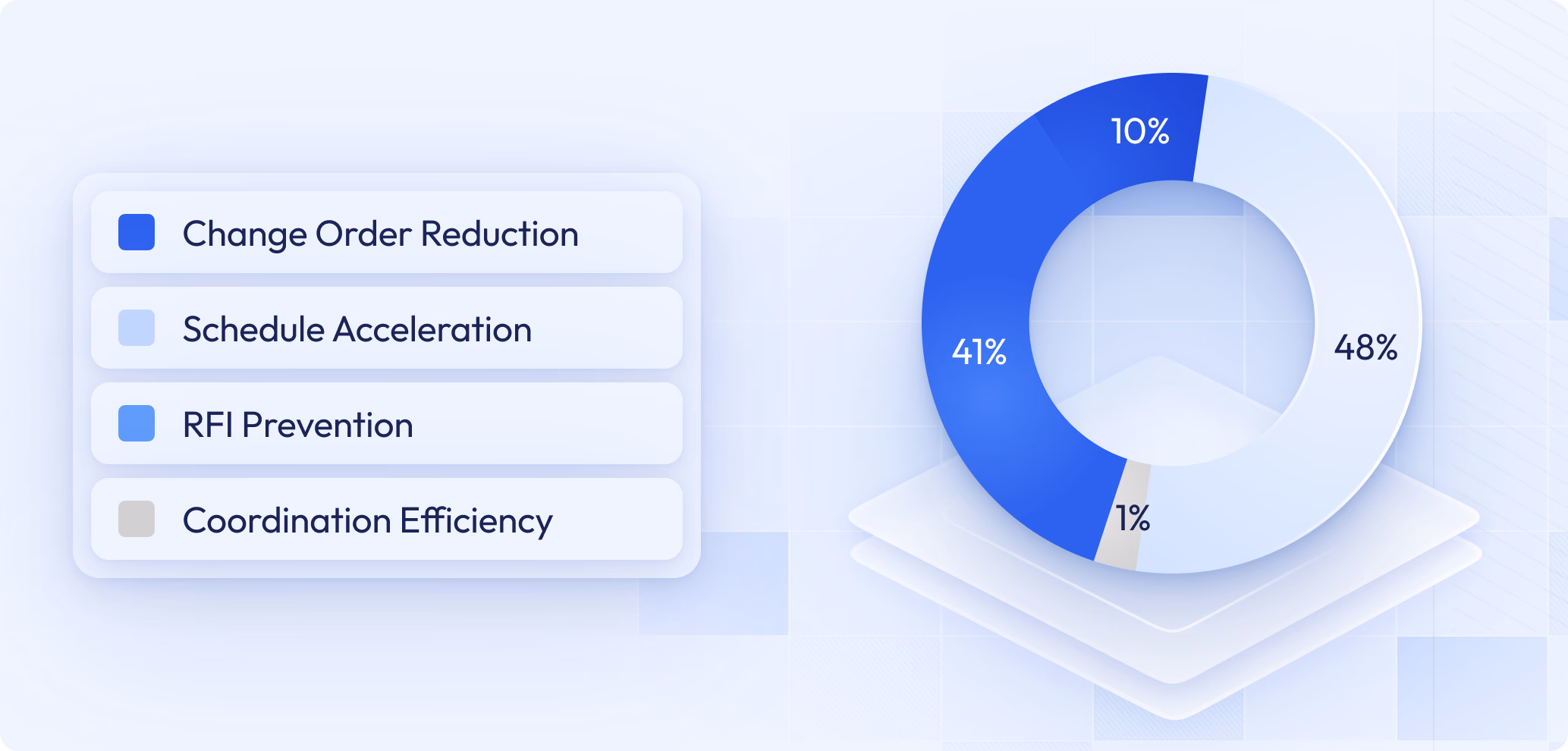

The proof of concept set out to show more than 10x ROI. It delivered 18.8x — with schedule protection (48%) and RFI reduction (41%) as the primary value drivers.
in savings per project (average)
caught before construction
avoided per project
in value per sheet reviewed
